Photos of the construction process.
  •  11/5/19 - The project begins.

    Kea Custom Boats SB6 11/5/19 - The project begins.

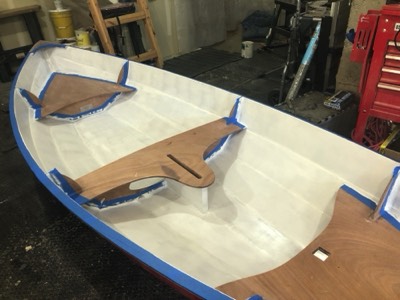

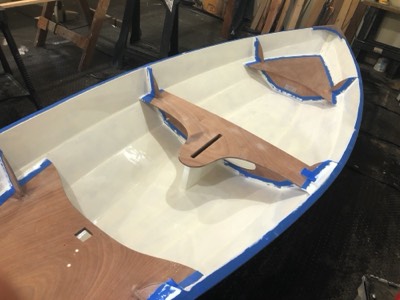

  •  11/12/19 - The hull seams are filled with epoxy.

    Kea Custom Boats SB6 11/12/19 - The hull seams are filled with epoxy.

  •  11/13/19 - Rudder trunk pieces are fiberglassed.

    Kea Custom Boats SB6 11/13/19 - Rudder trunk pieces are fiberglassed.

  •  Skeg wormshoe is epoxied in place.

    Kea Custom Boats SB6 Skeg wormshoe is epoxied in place.

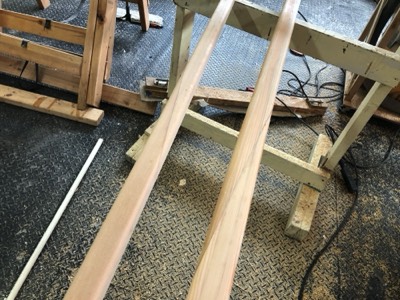

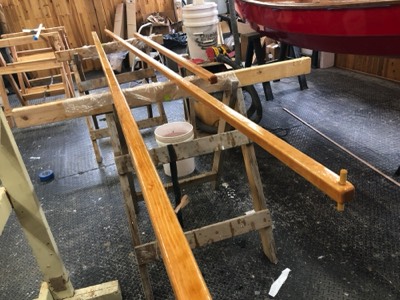

  •  The spars are epoxied to full length.

    Kea Custom Boats SB6 The spars are epoxied to full length.

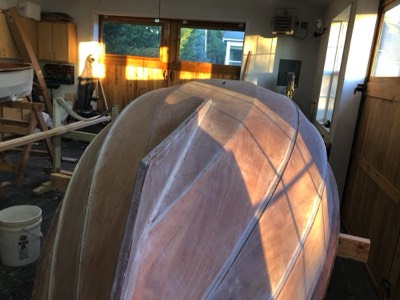

  •  11/16/19 - The first seal coat of epoxy is applied to the hull.

    Kea Custom Boats SB6 11/16/19 - The first seal coat of epoxy is applied to the hull.

  •  11/17/19 - The second seal coat is applied.

    Kea Custom Boats SB6 11/17/19 - The second seal coat is applied.

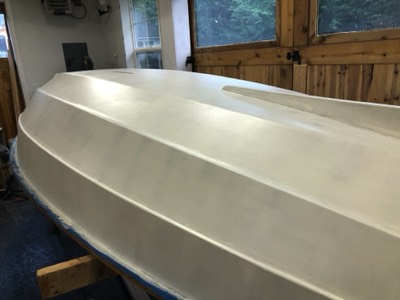

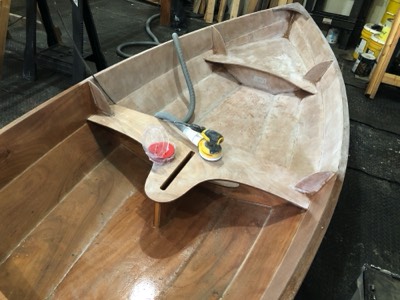

  •  11/20/19 - The hull is partially sanded.

    Kea Custom Boats SB6 11/20/19 - The hull is partially sanded.

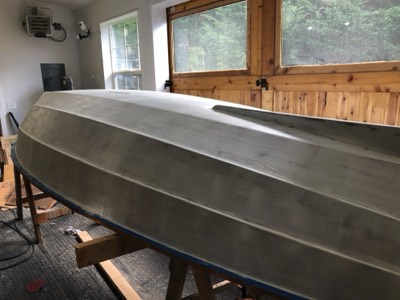

  •  The hull is sanded and ready for primer.

    Kea Custom Boats SB6 The hull is sanded and ready for primer.

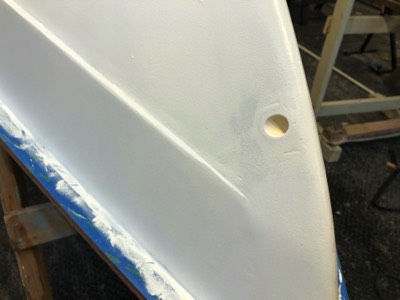

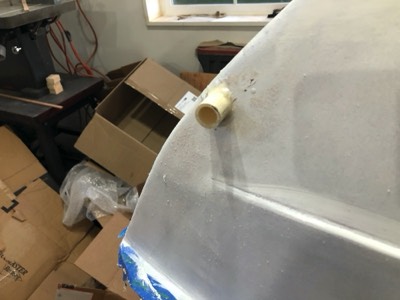

  •  11/24/19 - A PVC tow eye is installed.

    Kea Custom Boats SB6 11/24/19 - A PVC tow eye is installed.

  •  11/25/19 - The first coat of primer is sanded.

    Kea Custom Boats SB6 11/25/19 - The first coat of primer is sanded.

  •  Second coat of primer is applied.

    Kea Custom Boats SB6 Second coat of primer is applied.

  •  PVC is trimmed and sanded.

    Kea Custom Boats SB6 PVC is trimmed and sanded.

  •  11/26/19 - The primer is sanded.

    Kea Custom Boats SB6 11/26/19 - The primer is sanded.

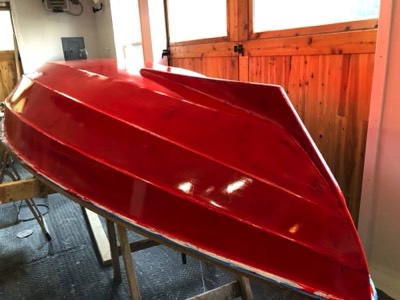

  •  11/27/19 - The first coat of paint is appiled.

    Kea Custom Boats SB6 11/27/19 - The first coat of paint is appiled.

  •  12/1/19 - The second coat of paint is on.

    Kea Custom Boats SB6 12/1/19 - The second coat of paint is on.

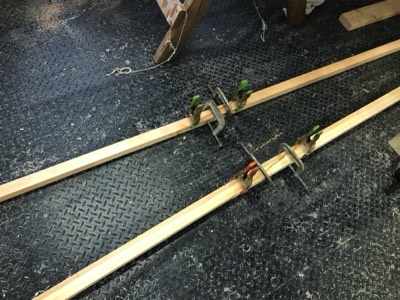

  •  12/3/19 - The spars are sanded.

    Kea Custom Boats SB6 12/3/19 - The spars are sanded.

  •  Four coats of paint are applied.

    Kea Custom Boats SB6 Four coats of paint are applied.

  •  12/5/19 - Work on the interior begins!

    Kea Custom Boats SB6 12/5/19 - Work on the interior begins!

  •  One seal coat of epoxy is applied.

    Kea Custom Boats SB6 One seal coat of epoxy is applied.

  •  Two seal coats of epoxy.

    Kea Custom Boats SB6 Two seal coats of epoxy.

  •  12/6/19 - The first seal coat of epoxy is applied to the spars.

    Kea Custom Boats SB6 12/6/19 - The first seal coat of epoxy is applied to the spars.

  • Kea Custom Boats SB6

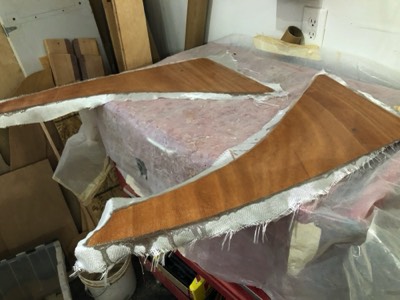

  •  Foils are fiberglassed.

    Kea Custom Boats SB6 Foils are fiberglassed.

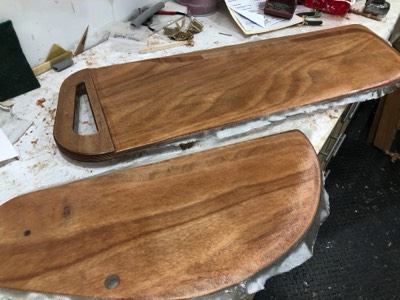

  •  Mahogany footbraces are sealed with epoxy.

    Kea Custom Boats SB6 Mahogany footbraces are sealed with epoxy.

  •  12/10/19 - Seal coats of epoxy are applied.

    Kea Custom Boats SB6 12/10/19 - Seal coats of epoxy are applied.

  •  Final seal coat of epoxy is applied to the spars.

    Kea Custom Boats SB6 Final seal coat of epoxy is applied to the spars.

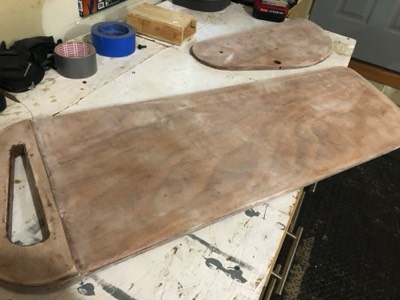

  •  Spacers for rudder gudgeons are epoxied in place.

    Kea Custom Boats SB6 Spacers for rudder gudgeons are epoxied in place.

  •  The rudder is test mounted.

    Kea Custom Boats SB6 The rudder is test mounted.

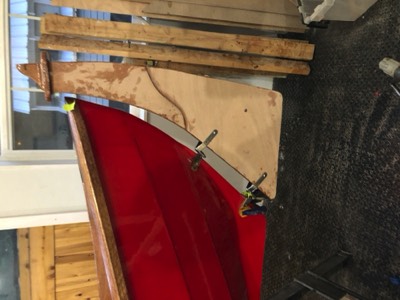

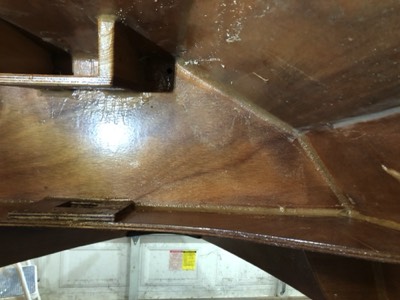

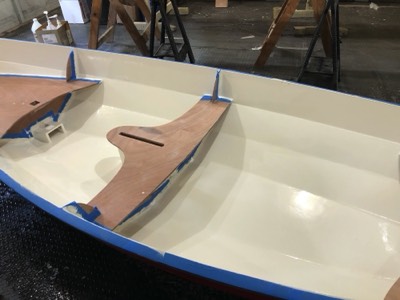

  •  3/11/20 - The underside of the seat/bulkhead joint is filletted.

    Kea Custom Boats SB6 3/11/20 - The underside of the seat/bulkhead joint is filletted.

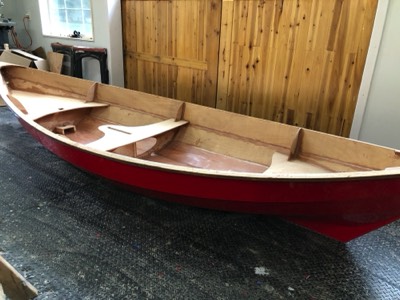

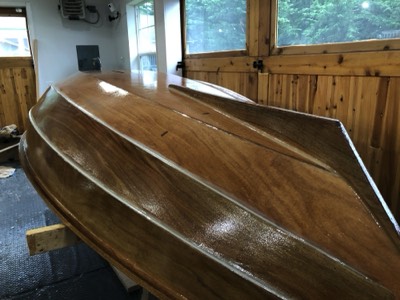

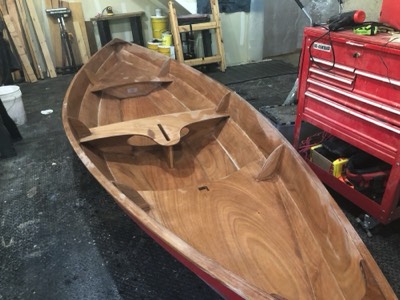

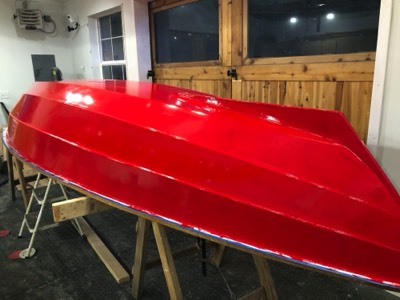

  •  3/12/20 - The final coat of paint is applied to the hull.

    Kea Custom Boats SB6 3/12/20 - The final coat of paint is applied to the hull.

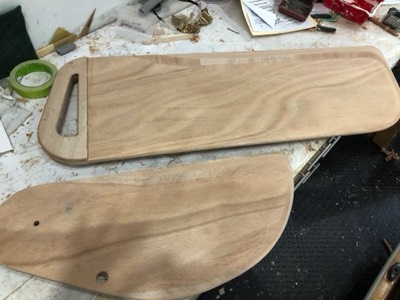

  •  3/14/20 - The foils are sanded.

    Kea Custom Boats SB6 3/14/20 - The foils are sanded.

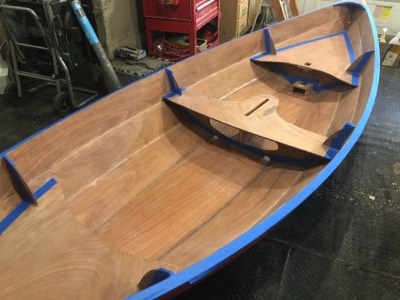

  •  3/17/20 - The interior is half sanded.

    Kea Custom Boats SB6 3/17/20 - The interior is half sanded.

  •  Sanding of the interior is complete.�

    Kea Custom Boats SB6 Sanding of the interior is complete.�

  •  3/18/20 - The interior is washed.

    Kea Custom Boats SB6 3/18/20 - The interior is washed.

  •  The interior is taped off in preparation for primer.

    Kea Custom Boats SB6 The interior is taped off in preparation for primer.

  •  3/19/20 - The first coat of primer is applied to the interior.�

    Kea Custom Boats SB6 3/19/20 - The first coat of primer is applied to the interior.�

  •  3/20/20 - The first coat of paint is applied.

    Kea Custom Boats SB6 3/20/20 - The first coat of paint is applied.

  •  3/23/20 - Second coat of paint is applied.

    Kea Custom Boats SB6 3/23/20 - Second coat of paint is applied.

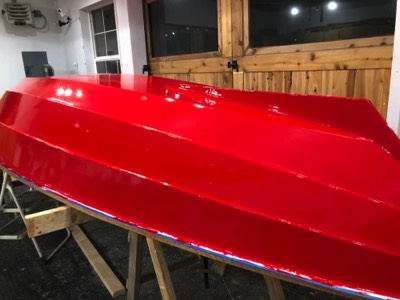

  •  3/24/20 - The final coat of paint is applied.

    Kea Custom Boats SB6 3/24/20 - The final coat of paint is applied.

  •  3/25/20 - The tape is removed and the boat is ready for varnish.

    Kea Custom Boats SB6 3/25/20 - The tape is removed and the boat is ready for varnish.

  •  3/26/20 - The first coat of varnish is applied to the seats and bulkheads.

    Kea Custom Boats SB6 3/26/20 - The first coat of varnish is applied to the seats and bulkheads.

  •  The spars get a coat of varnish.

    Kea Custom Boats SB6 The spars get a coat of varnish.

  •  Rudder and daggerboard are varnished.

    Kea Custom Boats SB6 Rudder and daggerboard are varnished.

  •  3/27/20 - Two more coats of varnish have been applied.

    Kea Custom Boats SB6 3/27/20 - Two more coats of varnish have been applied.

  •  4/1/20 - Footbraces are epoxied in place.

    Kea Custom Boats SB6 4/1/20 - Footbraces are epoxied in place.

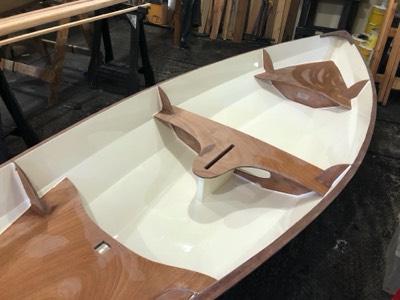

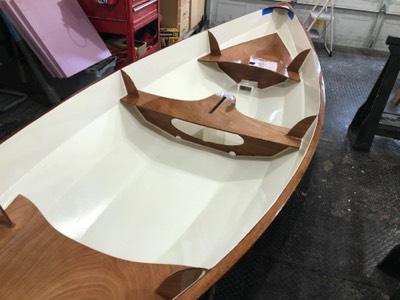

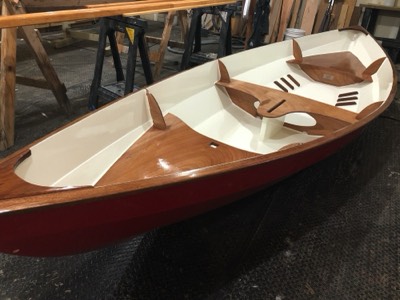

  •  Major construction is complete!

    Kea Custom Boats SB6 Major construction is complete!

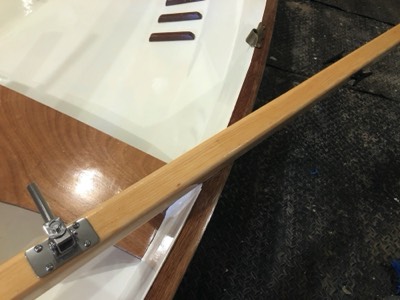

  •  Hardware is installed on mast.

    Kea Custom Boats SB6 Hardware is installed on mast.

  •  4/2/20 - The boat is moved outside to allow for rigging the sail.

    Kea Custom Boats SB6 4/2/20 - The boat is moved outside to allow for rigging the sail.

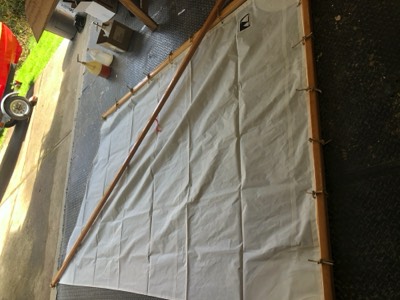

  •  The sail is fit to the spars.

    Kea Custom Boats SB6 The sail is fit to the spars.

  •  The sail rig is set up.

    Kea Custom Boats SB6 The sail rig is set up.

  •  The rudder is hung on the stern.

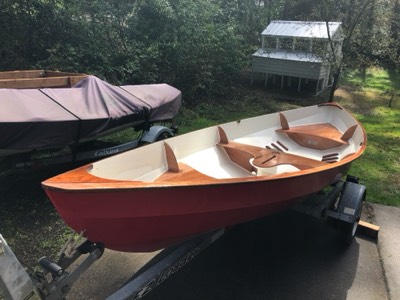

    Kea Custom Boats SB6 The rudder is hung on the stern.
