7/29/08 - A view of the plans from CLC.
-

The first step is to trace the full sized patterns for various parts of the rig.
-
7/31/08 - Bulkheads and mast parter pieces are drawn onto a piece of plywood.
-
The bulk heads are rough cut from the ply.
-

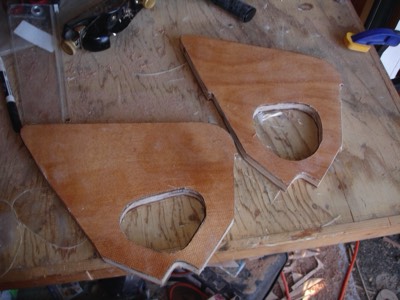

The bulkheads are cut down to shape.
-
The bulkheads are laminated together. Altogether, the laminated bulkheads equal about 19 mm. This is 10 more than the plans call for. I am doing this for extra strength for rough weather and for possible installation of nets later on.
-
8/2/08 - The hull panels are drawn out on plywood panels.
-
8/3/08 - The bulkheads are sanded to their final shape.
-
The bulkheads are fiberglassed.
-
This is an upper hull panel being cut out.
-

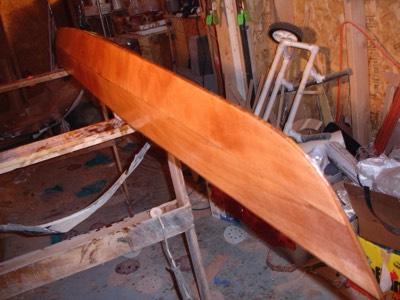

A finished upper stern hull panel.
-
This is a lower hull panel.
-

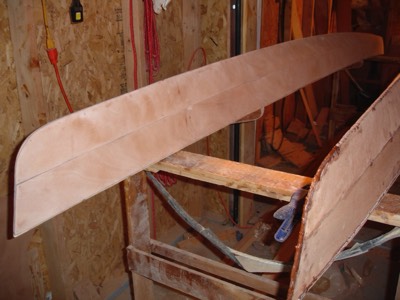

The panel is cut and shaped.
-

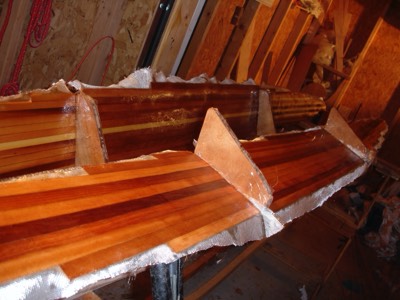

The bulkheads are ready to be stitched into the boat.
-
The for and aft sections are joined together using a butt joint.
-
The port ama is loosely stitched together.
-
Both amas are stitched up and ready for glue.
-
The port ama with the seams filled with epoxy.
-

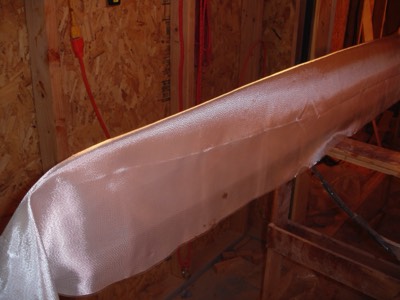

8/4/08 - The interiors of the amas are coated with epoxy for waterproofness. Also the seam between the panels was reinforced with fiberglass tape.
-
Sheer clamps are installed.
-
Ledge on the bulkhead for the deck to rest on.
-
Ledge on the bulkhead for the deck to rest on.
-
The starboard ama will have a hybrid strip deck.
-
The starboard ama bow.
-

The second aka is laminated only 3 strips at a time.
-
The deck is finished on the starboard ama.
-
The second aka gets two more strips of wood.
-
The port ama deck is stripped.
-
Since I used old damaged strips for the decks, I had to fill gaps between them with epoxy.
-
8/7/08 - The second aka is fully laminated.
-
8/8/08 - The decks of the amas are sanded smooth.
-
8/9/08 - Wood is cut for the large rudder. I am using a single sized SmartTrack rudder as a core for this one. This way I can still use the ST linkage.
-
8/10/08 - Sheets of plywood and a piece of bloodwood are epoxied together for use as the leeboard.
-
Fiberglass cloth is laid out on the decks of the amas.
-
8/11/08 - The starboard ama deck is fiberglassed.
-
The leeboard is cut out.
-
Both ama decks are 'glassed and fill coated.
-
The extend rudder I am making for the rig. Bronze nails are used to keep the rudder insert in place.
-
The leeboard is rounded and smoothed.
-
8/12/08 - The undersides of the decks are fiberglassed.
-
The rudder and leeboard are sanded and ready for fiberglass.
-
Both are fiberglassed.
-
The decks are epoxied onto the amas.
-
8/14/08 - The aka spacers are assembled.
-
The leeboard gets a fill coat of epoxy on both sideas at once.
-
The amas are sanded smooth. Here you can see the difference pre and post sanding.
-
8/15/08 - The amas are sanded and ready for fiberglass.
-
Glass cloth is laid out.
-
One ama is fiberglassed.
-
The aka spacers are sealed with epoxy.
-
The other ama is fiberglassed.
-
8/16/08 - The mast step is assembled. The hole is irregular because the mast has a rectangular piece at the bottom.
-
The hole is cut for the mast in the mast partner. It is also sealed with epoxy.
-
Both amas get a couple fill coats of epoxy. The white line is not a scratch, it is a discolored section of the plywood.
-
8/17/08 - The aka spacers are attached to the akas.
-

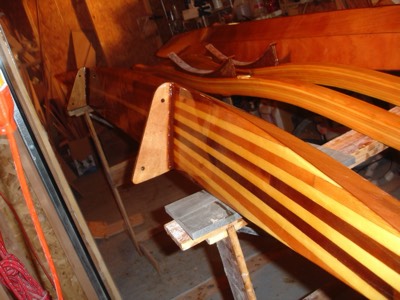

8/18/08 - The bulkheads are reinforced with epoxy fillets. This completes the construction of the amas. I only have to sand and varnish them.
-
The mast partner is attached to the forward aka.
-
The mast step is sealed with epoxy.
-
8/19/08 - The akas and amas are laid out.
-
The akas are trimmed to their proper length.
-

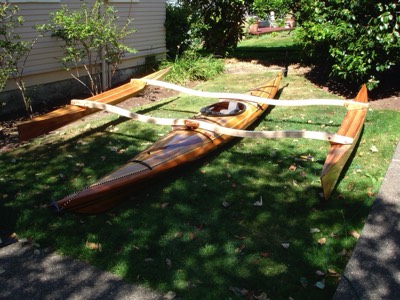

After holes are drilled for bolts in the amas they are put together and laid on the kayak.
-
A hole (gulp!) is cut in the kayak for the mast. This hole will act like a tiny hatch. The hatch lip has a round mast sized hole.
-
The mast is test fit onto the boat.
-
The mast step is installed.
-
The akas are sanded smooth.
-
8/22/08 - The sail rig is set up!
-
All the fittings for the halyards and sheets are installed onto the akas.
-
The akas get the first seal coat of epoxy.
-
9/28/08 - A new rudder that will work with a tiller is being built.
-
The rudder and other pieces are ready for fiberglass.
-
Everything has fiberglass on one side.
-
9/29/08 - The wood for the tiller is fiberglassed.
-
10/3/08 - All the parts are varnished.
-
10/3/08 - All the parts are varnished.
-

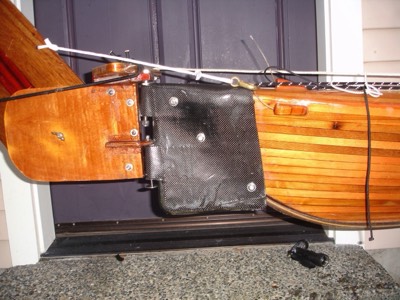

12/13/08 - After some sea trials a reinforced carbon fiber end cap was built as a rudder mount.
-
8/26/08 - Everything has been sanded and varnishing has begun. A good view of the leeboard.
-
The amas and akas get a couple of coats of varnish.
-
8/27/08 - The decks of the amas and the lower side of the akas are varnished.
-
8/28/08 - All the pieces are in place.
