1/31/24 - The kit is opened and unpacked.
-
2/1/24 - The bottom panel is epoxied to full length.
-
Side panles are epoxied together.
-

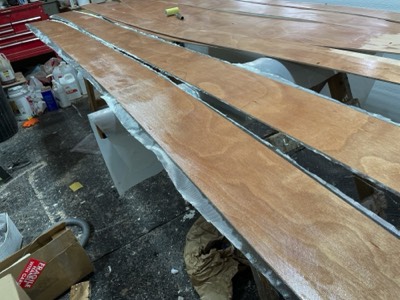

2/2/24 - The hull panels are laid out.
-
The hull panels are fiberglassed on one side.
-
2/5/24 - The #3 hull panels are fiberglassed.
-
Transom and seat bulkhead are fiberglassed.
-

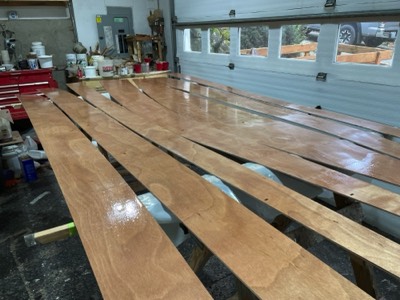

2/7/24 - The hull panels are given some fill coats of epoxy.
-
Bulkhead and transom are epoxy sealed.
-
2/12/24 - The bottom and #1 panels are wired to the forward bulkheads.
-
The aft bulkhead and transom are wired in place.
-

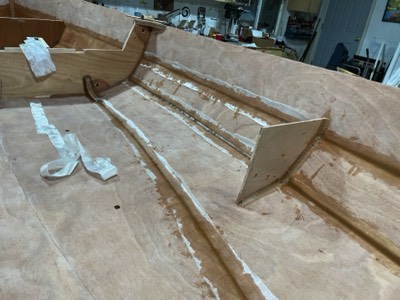

The hull is wired together.
-
Rails are epoxied to full length.
-
Various parts are fiberglassed.
-
2/13/24 - The rails are epoxied in place.
-
2/14/24 - The boat is flipped over.
-
Wires are tightened and seams epoxied.
-
Inside faces of rudder and daggerboard trunk are coated with epoxy and graphite powder.
-
2/15/24 - Bow reinforcement piece is epoxied in place.
-
Transom knee/support is epoxied in place.
-
2/16/24 - The forward bulkhead and mast step are epoxied in place.
-
2/22/24 - Take apart bulkheads are ready for fiberglass reinforcment around the areas for the bolts.
-
The glass is saturated with epoxy.
-
2/26/24 - Double sided tape is added to the bulkhead.
-
The bulkhead is epoxied in place.
-
2/27/24 - Fiberglass tape is laid on the joints between panels.
-
Joints are filletted and the fiberglass tape is saturated with epoxy.
-
2/28/24 - Half of the aft section is filletted and taped.
-
3/1/24 - Through hull fitting tube is epoxied in place.
-
Mast partner is epoxied in place.
-
3/5/24 - Two halves of the forward deck are epoxied together.
-
3/6/24 - Reinforcements are epoxied on the deck.
-
Knees are fiberglassed.
-
3/7/24 - Aft seat parts are ready for fiberglass.
-
The glass is covered with epoxy.
-
3/8/24 - The aft seat parts are test fit.
-
3/12/24 - The inner hatch rim is epoxied in place.
-
3/13/24 - Aft seat sides are filleted on the inside.
-
3/14/24 - The underside of the deck is epoxy sealed.
-
3/22/24 - The top side of the forward deck is fiberglassed.
-
3/25/24 - The aft seats are filleted.
-
Mast support tube is epoxied in place.
-
Take apart bolts are epoxied in place.
-
3/26/24 - Aft seat corners are fiberglassed and a fill coat is applied.
-
Fill coat of epoxy is applied to the deck.
-
3/27/24 - In the process of cutting the boat in half!
-
The boat is in two halves.
-
Deck supports are epoxied in place.
-
3/28/24 - The sockets for the take-apart bolts are filled with epoxy.
-
4/5/24 - The edges of the hull halves are reinforced with epoxy.
-
4/6/24 - The outside faces of the take apart bulkheads are fiberglassed.
-
4/7/24 - The forward deck is epoxied in place.
-
4/8/24 - The deck is filleted.
-

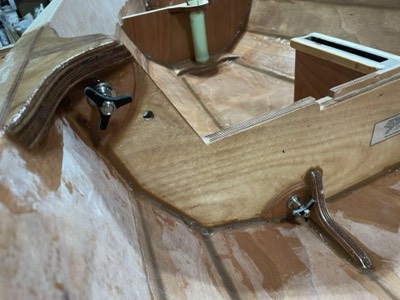

Gudgeons and pintles are temporarily mounted.
-
The slot for the daggerboard is cut.
-
Gaps are filled with epoxy.
-
4/9/24 - The foils are fiberglassed on one side.
-
The aft section is half sanded.
-
The entire hull is sanded and ready for fiberglass.
-
4/10/24 - Fiberglass cloth is laid on the hull.
-
4/11/24 - The cloth is epoxy saturated.
-
4/12/24 - The hull bottom is ready for fiberglass.
-
4/17/24 - The transom and skeg are prepped for fiberglassing.
-
Transom and skeg are fiberglassed.
-
4/22/24 - The hole for the daggerboard is cut.
-
Wear strips are epoxied in place.
-
4/24/24 - The aft section is half sanded.
-
Aft section is sanded.
-
4/28/24 - The tops of the rails are fiberglassed.
-
4/29/24 - The rail sides are fiberglassed.
-
5/1/24 - The ralis are given a final fill coat of epoxy.
-
5/2/24 - The topsides are sanded and ready for finishing.
-

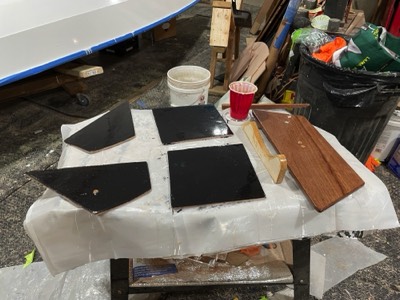

5/3/24 - Carbon fiber alignment clips are temporarily mounted.
-
First coat of primer is applied to the hull.
-
5/6/24 - The primer is sanded.
-
First coat of paint is applied.
-
5/28/24 - Various parts are given the first coat of varnish.
-
The interior gets the first coat of varnish.
-
Foils get first coat of varnish.
-
6/5/24 - Rowing footrests are epoxied in place.
