8/12/21 - The box is opened.
-
Bulkhead and transom pieces are laid out.
-
One of the take apart bulkheads is epoxied together.
-
8/17/21 - #1 and #2 panels are wired to the bottom with the temporary bulkhead.
-
Take apart bolts are epoxied in place.
-

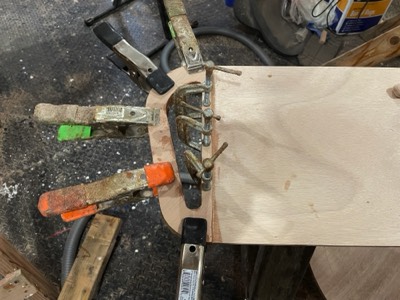

Daggerboard trunk is epoxied together.
-
8/18/21 - The hull is wired up.
-
9/2/21 - The joints between panels are filled with epoxy.
-
9/10/21 - Fillets are added to the bulkheads, transoms, and joints between bottom and #1 panels.
-
9/13/21 - Fiberglass cloth is laid out.
-
The cloth is saturated with epoxy.
-
The extra cloth is trimmed.
-
9/14/21 - The daggerboard trunk is epoxied in place.
-
9/27/21 - The seat supports are epoxied in place.
-
The two skeg halves are epoxied together.
-
The outboard doubler is epoxied in place.
-
10/1/21 - The skeg is temporarily mounted.
-
The undersides of the seat supports are reinforced with fillets and fiberglass tape.
-
Rails are epoxied in place.
-
10/4/21 - Fiberglass is laid on the outside of the hull.
-
The glass is saturated with epoxy.
-
The skeg is screwed and epoxied in place.
-
Test fitting the skids.
-
The skids are screwed and epoxied in place.
-
10/5/21 - Quarter knees are epoxied in place.
-
10/6/21 - It is time to saw the boat in half!
-
The boat is cut in half.
-
10/7/21 - The mast step is screwed and epoxied in place.
-
10/8/21 - The hole for the daggerboard is cut out.
-
10/11/21 - The outside of the hull is given a seat coat of epoxy.
-
10/14/21 - Handles for daggerboard are laminated together.
-
Interior of aft section is given a seal coat of epoxy.
-
10/20/21 - The gudgeons and pintles are temporarily mounted.
-
Forward oarlocks are temporarily mounted.
-
Aft oarlock risers are epoxied in place.
-
10/21/21 - The Rudder and daggerboard are shaped.
-
Rudder is fiberglassed and forward seat is sealed with epoxy.
-
10/25/21 - The hull has been sanded in preparation for primer.
-
10/26/21 - The hull is taped off for primer.
-
First coat of primer.
-

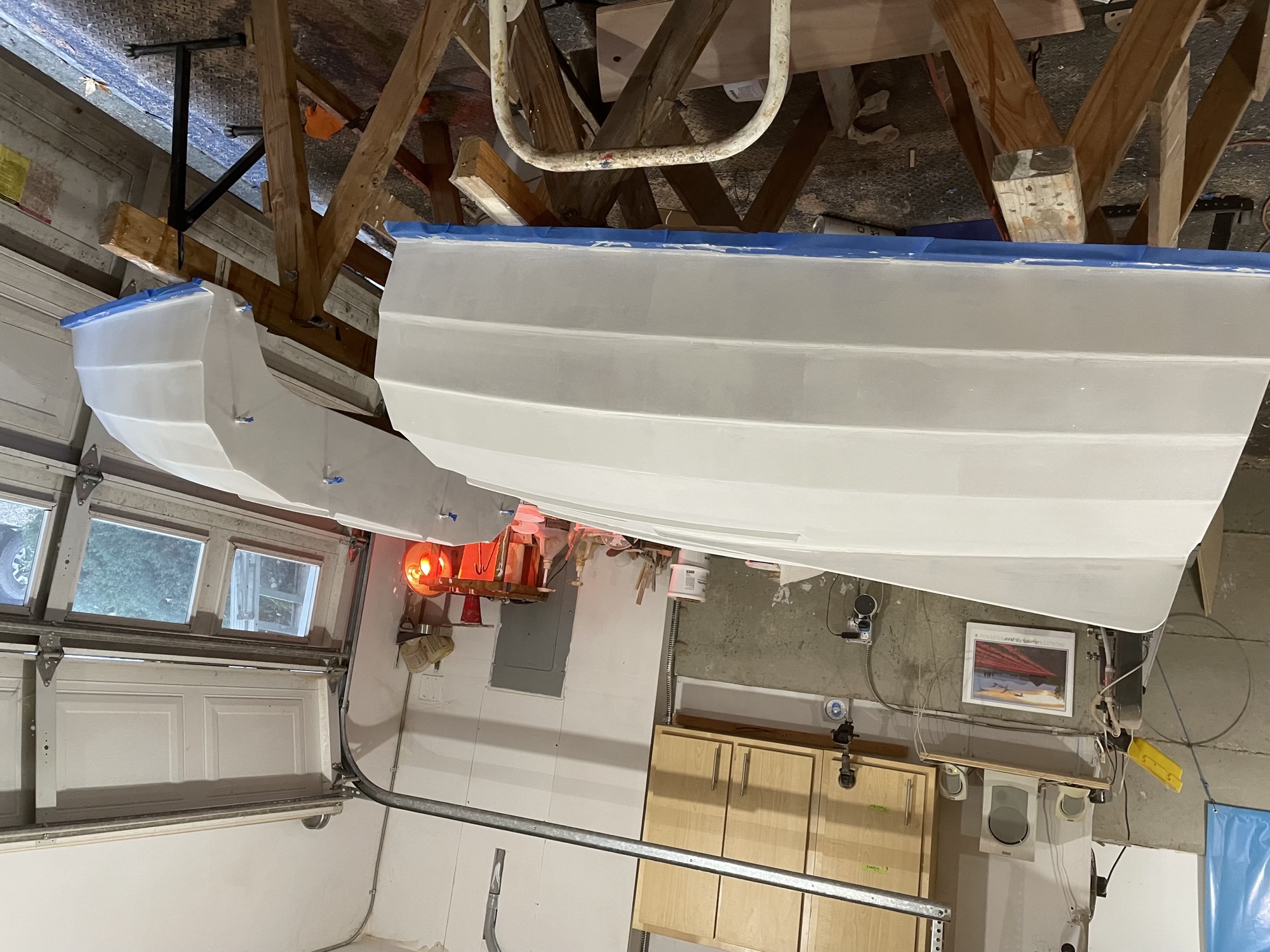

10/28/21 - The two coats of primer have been sanded. Ready for paint!
-
10/29/21 -The first coat of paint is applied.
-
10/30/21 - Two coats of paint.
-
11/1/21 - Parts are sealed with epoxy.
-
11/2/21 - The entire interior is given a seal coat of epoxy.
-
Spars are sealed with epoxy.
-
11/5/21 - Sanding in proparation for varnish has begun.
-
Spars, seats, and foils are sanded.
-
11/8/21 - Foam for underseat reserve floatation is epoxied together.
-
11/9/21 - Sanding is complete. The boat is ready for varnish.
-
The foam pieces are epoxied to the underside of the seats.
-
11/10/21 - The foam is shaped.
-
The foam is covered with epoxy.
-
11/11/21 - The foils and spars are varnished.
-
Foam is given another coat of epoxy.
-

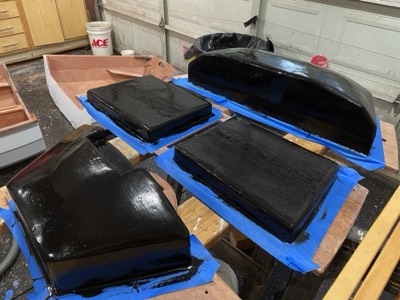

11/12/21 - The foam blocks are sanded and painted.
-
11/15/21 - The first coat of varnish is applied.
-
Tops of the seats are varnished.
-

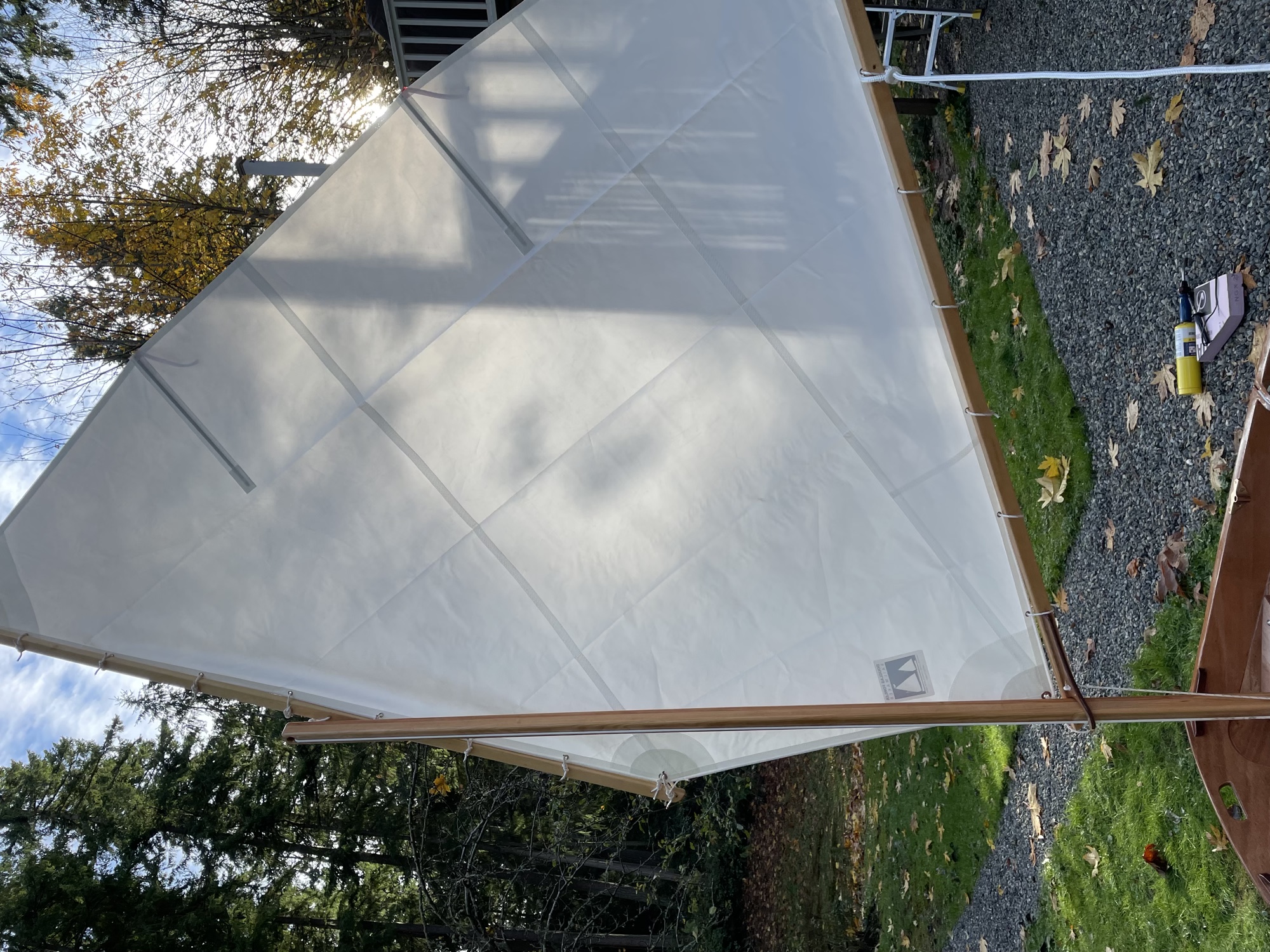

11/17/21 - The sail is rigged and the boat is complete!
